Stage Gates
Evidence-based advancement — what each gate asks for and exactly where to complete it.
Products advance through seven lifecycle stages: IDEA → RESEARCH → VALIDATE → BUILD → LAUNCH → MRR → SCALE, with MAINTAIN, PARK, and KILL as deliberate exits. The order is enforced, not decorative: a product in BUILD went through RESEARCH and VALIDATE first, and each transition is a gate: a checklist of evidence that must exist before the product advances. The header status row shows exactly where a product sits on that path.
Why gates exist
The failure mode of solo portfolios is momentum theater — working on whatever is fun and calling it progress. Gates make the honest question explicit: what has been proven, and what hasn't?
- Gates define required evidence (for example, VALIDATE → BUILD requires evidence of demand from real target users).
- Every gate decision is logged to the product's decision history with a rationale — required, not optional.
- Overrides exist (founders sometimes know best), but they are recorded and visible in portfolio reviews.

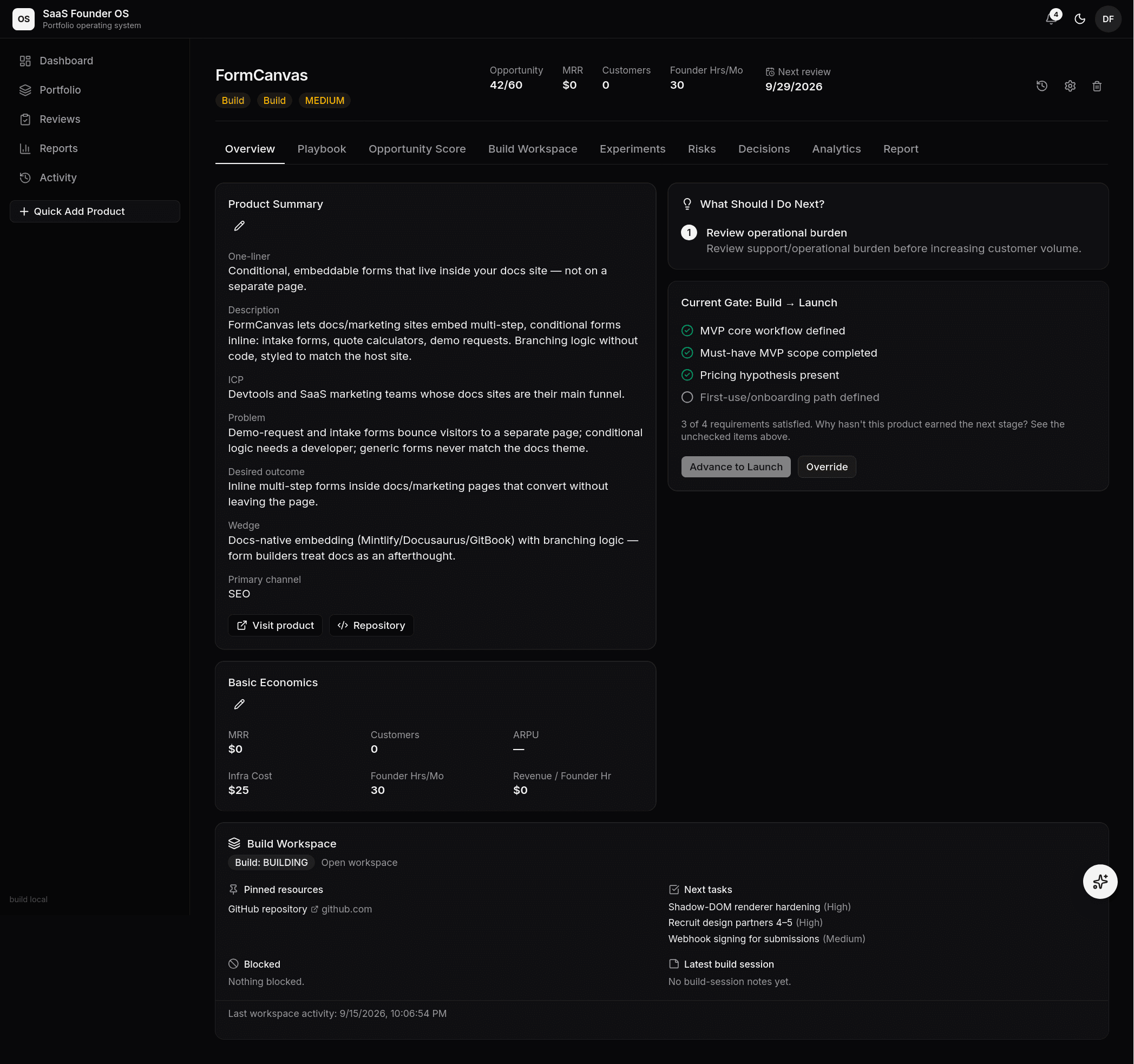

A gate in progress — three of four requirements satisfied, so "Advance"
stays disabled until the last piece of evidence exists (or you record an
explicit override).
How you step through a gate
Everything happens in one place: the product's Overview → Current Gate card. It lists every requirement with a ✓ or ○, and each unsatisfied row is a link that takes you straight to the spot where that evidence lives. The loop:
- Open the product. The Current Gate card shows what's done and what's missing.
- Click a missing requirement's link — it lands you on the exact field, Playbook section, or tab that satisfies it.
- Fill it in (most Playbook fields can be AI-drafted, then confirmed).
- Back on the Overview, the card re-checks itself. When every box is ✓ the Advance button unlocks — advancing records a decision in the product's Decision History.
In the Playbook's section nav, every section that feeds a gate carries a badge (e.g. G1, G2,3) naming the gate(s) it moves, and each section page shows "Feeds gate …" at the top — so you always know which checklist your work is advancing. Sections without a badge don't feed any gate.
The gate map below shows every requirement and its click path, so you always know where to go before you get there.
The gate map
Gate 1 · Research → Validate
| Requirement | Where to complete it |
|---|---|
| ICP defined | Product Overview — the summary card's ICP field |
| Problem defined | Product Overview — the summary card's Problem field |
| Desired outcome defined | Product Overview — the summary card |
| At least 3 competitors or credible evidence points | Playbook › Market Proof — add 3+ rows to the Competitors list |
| Wedge defined | Product Overview — the summary card's Wedge field |
| Opportunity score completed | Opportunity Score tab — all 12 criteria scored |
Gate 2 · Validate → Build
| Requirement | Where to complete it |
|---|---|
| Validation hypothesis defined | Playbook › Paid Validation — Validation hypothesis |
| Paid/founder offer OR willingness-to-pay evidence | Playbook › Paid Validation — Founder offer or Willingness-to-pay evidence |
| Success criteria defined | Playbook › Paid Validation — Success criteria |
| At least one validation experiment completed | Experiments tab — add an experiment and mark it Completed |
Gate 3 · Build → Launch
| Requirement | Where to complete it |
|---|---|
| MVP core workflow defined | Playbook › MVP Definition — Workflow input, process, and result |
| Must-have MVP scope completed | Playbook › MVP Definition — the Must-have list (at least one item) |
| Pricing hypothesis present | Playbook › Paid Validation — Pricing hypothesis |
| First-use/onboarding path defined | Playbook › Distribution — Primary channel |
Gate 4 · Launch → MRR
| Requirement | Where to complete it |
|---|---|
| At least one paying customer OR MRR > 0 | Your live data feed reporting MRR, or a manual MRR on Build › Economics |
| First-customer learning recorded | Playbook › Customer Learning Loop — complete the section |
Gate 5 · MRR → Scale
| Requirement | Where to complete it |
|---|---|
| Explicit scale decision | Playbook › Portfolio Decision — Actual decision |
| Scale rationale recorded | Playbook › Portfolio Decision — Rationale |
| Supporting evidence recorded | Playbook › Portfolio Decision — Strongest evidence |
| Economics reviewed | Playbook › Portfolio Decision — Economics (keep consistent with Build › Economics) |
| Major risks reviewed | Risks tab — record the risk (the Portfolio Decision's Biggest risk field also satisfies this) |
The exits (MAINTAIN, PARK, KILL, and SCALE itself)
These stages have no automatic forward gate. You move a product into (or between) them from the Reviews screen by recording a portfolio decision — which is itself logged to the Decision History with a rationale. This is deliberate: ending or resting a product is a decision you make in review, not a checklist you satisfy.
Blocked or disagree?
If a gate is holding a product back but you know better, the gate card offers an override — it moves the stage and records the override (and your reason) in the Decision History, so the review trail stays honest.
The next-action engine
Underneath the gates sits a deterministic engine that prioritizes 1–5 concrete next actions per product — which experiment to run, which evidence to collect next — based on the current stage and missing gate requirements. If you open the app and don't know what to do, the next-action engine is the answer.
